How long does it take to manufacture golf balls? For China OEM orders, the answer should be read by construction lane, approval trigger, packaging scope, QC release, and factory calendar.
After sample approval, a typical China OEM planning band is 15–25 days for 2-piece Surlyn golf balls, 18–30 days for 3-piece Surlyn golf balls, and 30–50+ days for 4-piece cast urethane golf balls before EXW release. These are production planning bands, not delivered-to-warehouse timelines; freight, customs, DDP, and final delivery belong in logistics planning.
Your order rarely fails because every supplier is “slow.” It fails when your team and the factory are watching different clocks: tooling, artwork, curing, coating, packaging, QC, rework, holiday capacity, and cargo-ready release.
Use this guide to understand which parts of the OEM golf ball production timeline can be compressed, which parts cannot, and what your team should freeze before the schedule starts slipping.
What Starts the OEM Production Timeline?

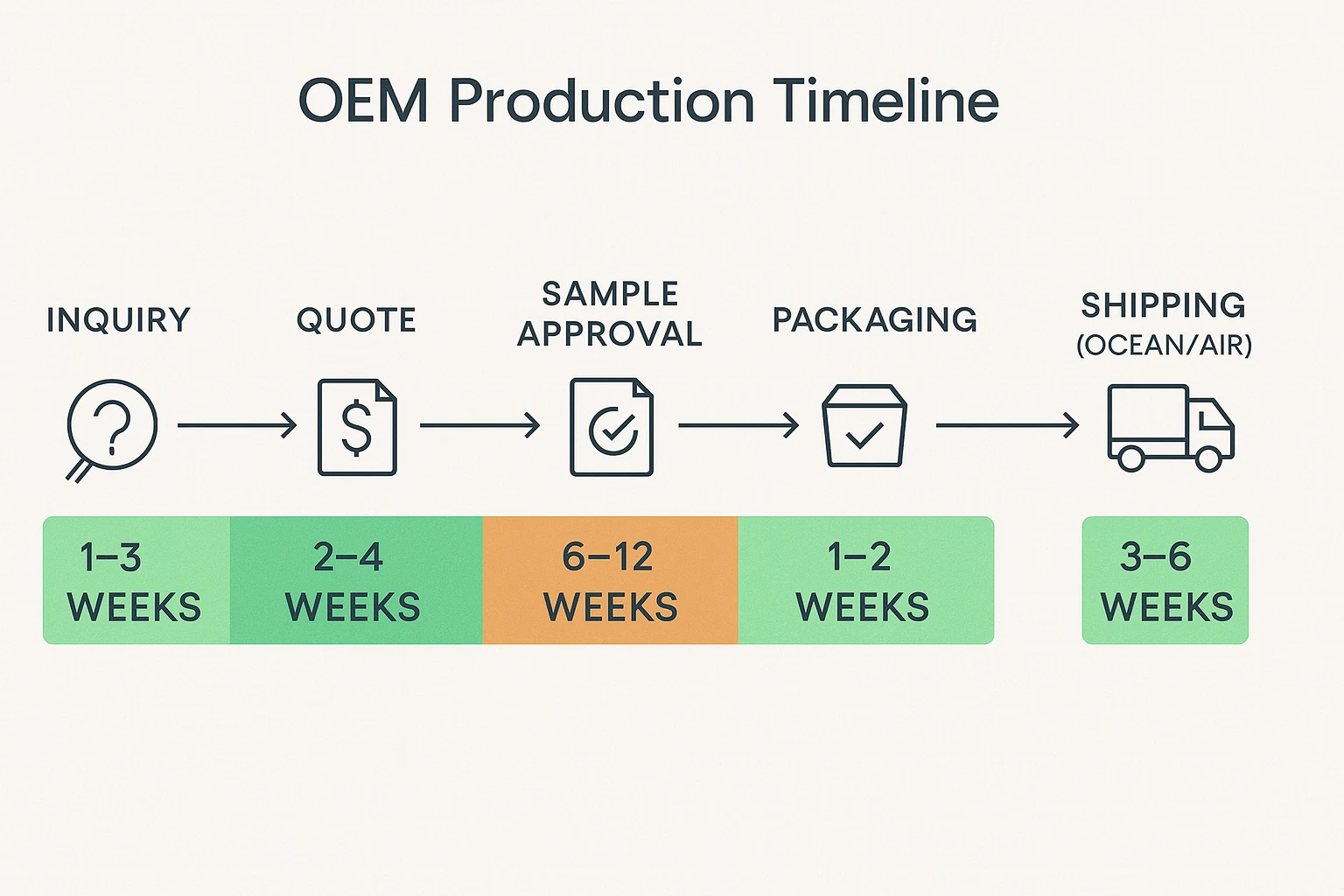

A golf ball production schedule is not reliable until the factory defines the start trigger. The timeline may start from deposit, artwork approval, golden sample approval, tooling approval, or mass-production release. Those are not the same date.
For OEM buyers, the safest production clock starts after the approved sample, confirmed artwork, frozen packaging, and written mass-production release. If a supplier says “25 days” but does not define the trigger, the quote is not a schedule yet.
| Timeline trigger | What it means | Buyer risk | What to confirm |
|---|---|---|---|
| Inquiry date | First discussion starts | Too early to plan production | Do not treat it as lead time. |
| Deposit date | Commercial order starts | Artwork, sample, or packaging may still be open | Confirm what remains unapproved. |
| Artwork approval | Logo and packaging files are approved | Ball construction may still be unconfirmed | Link artwork to sample and packaging version. |
| Golden sample approval | Buyer approves the physical sample | Packaging or tooling may still delay release | Confirm sample ID and release status. |
| Mass-production release | Factory can begin bulk production | The real production clock starts here | Request EXW schedule and QC gates. |
Ask your supplier to define the lead-time trigger in writing. The quote should show sample approval date, tooling status, material readiness, production window, packaging window, QC date, and EXW release date.
How Long Does Each Golf Ball Construction Take?

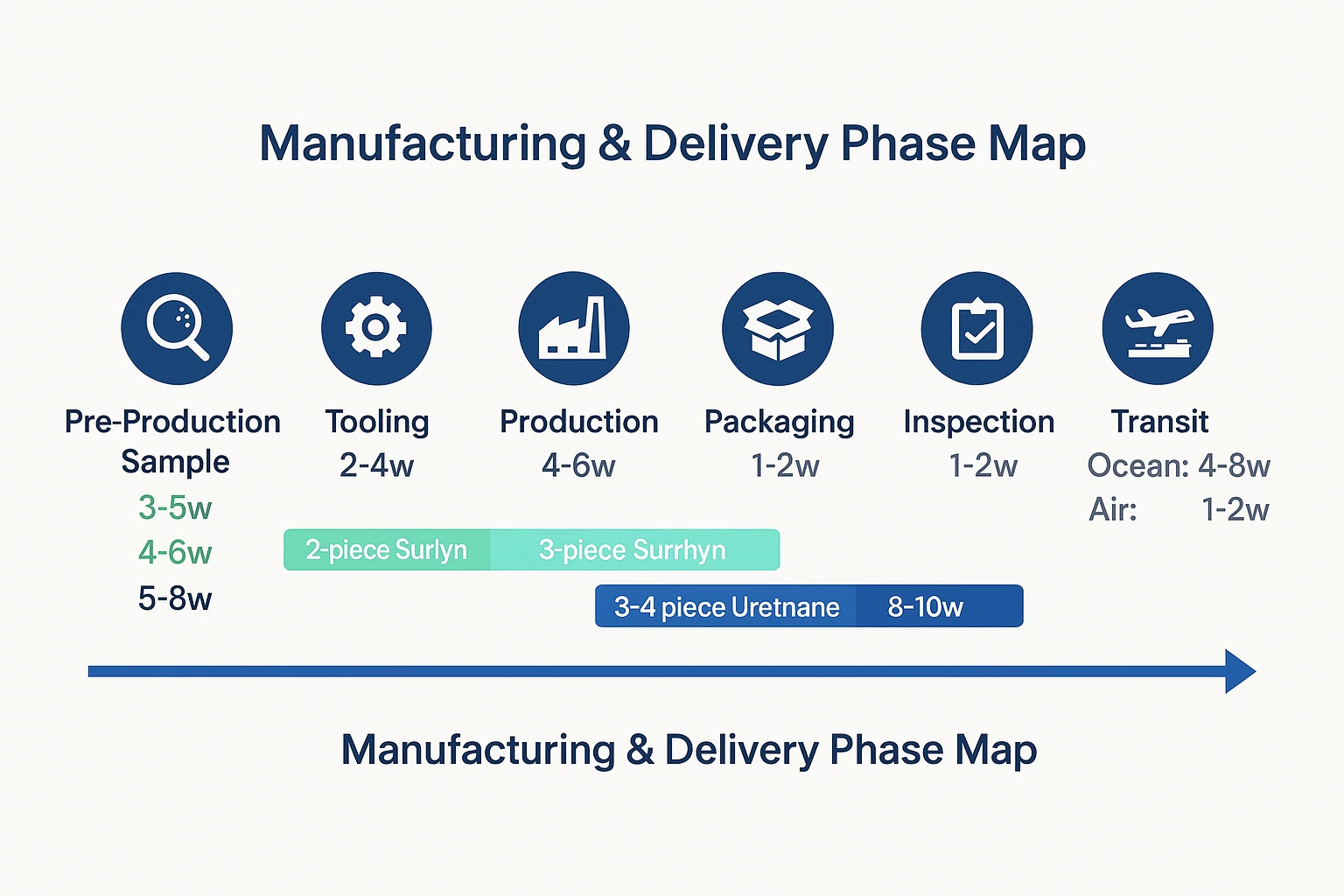

Golf ball lead time should be read by construction lane, not as one universal factory number. A simple Surlyn logo order, a 3-piece retail SKU, a cast urethane premium project, and a private-tooling program follow different process clocks.
After sample approval, a typical China OEM planning band is 15–25 days for 2-piece Surlyn golf balls, 18–30 days for 3-piece Surlyn golf balls, and 30–50+ days for 4-piece cast urethane golf balls before EXW release. These are production planning bands, not guaranteed delivery dates.
| Buyer decision | China OEM planning band after sample approval | What changes the calendar | Evidence to request |
|---|---|---|---|
| Fast promo, range, or academy order | 2-piece Surlyn: 15–25 days | stock material, logo method, packaging, line slot | Approved-sample-to-EXW schedule. |

| Mid-tier retail or DTC test SKU | 3-piece Surlyn: 18–30 days | mantle control, compression target, packaging scope | Construction and QC gate plan. |
| Premium cast-urethane SKU | 4-piece cast urethane: 30–50+ days | curing, coating, QA, scrap, rework | Curing buffer and release gate. |
| Private dimple or aerodynamic tooling | Add tooling window before production | CAD, CNC, polishing, trial molding, pilot validation | Tooling Gantt before PO. |
| Premium packaging or gift set | Add packaging buffer if not run in parallel | dieline, Pantone, insert, barcode, carton marks | Packaging freeze date and proof owner. |
Public tooling usually moves faster for first orders because the factory can avoid private dimple development and trial-mold correction. Private tooling may be useful for a mature brand, but it should be scheduled before the normal production clock.
Request a construction-based schedule showing sample approval date, tooling status, material readiness, production window, packaging window, QC date, and EXW release date. Verify whether the quoted lead time starts from inquiry, PO, deposit, artwork approval, sample approval, or mass-production release.
Supplier shall identify the approved production version by construction, cover system, tooling family, sample ID, batch ID, material route, packaging version, markings, finish, and release status. Any change to material, tooling, artwork, packaging, coating, or QC gate requires written buyer approval and schedule revision.
✔ True — Construction dictates the production calendar.
A fast Surlyn logo order and a cast-urethane premium order follow different process clocks. Your team should anchor timing by construction before discussing rush options.
✘ False — “A supplier can rush every golf ball SKU the same way.”
Rush potential depends on tooling, approved samples, materials, packaging files, line access, curing windows, and QC release gates.
Why Does Cast Urethane Take Longer?
Buyers often suspect delay when a Surlyn order moves quickly but a cast-urethane program takes longer. Usually, the calendar is chemistry, not politics.

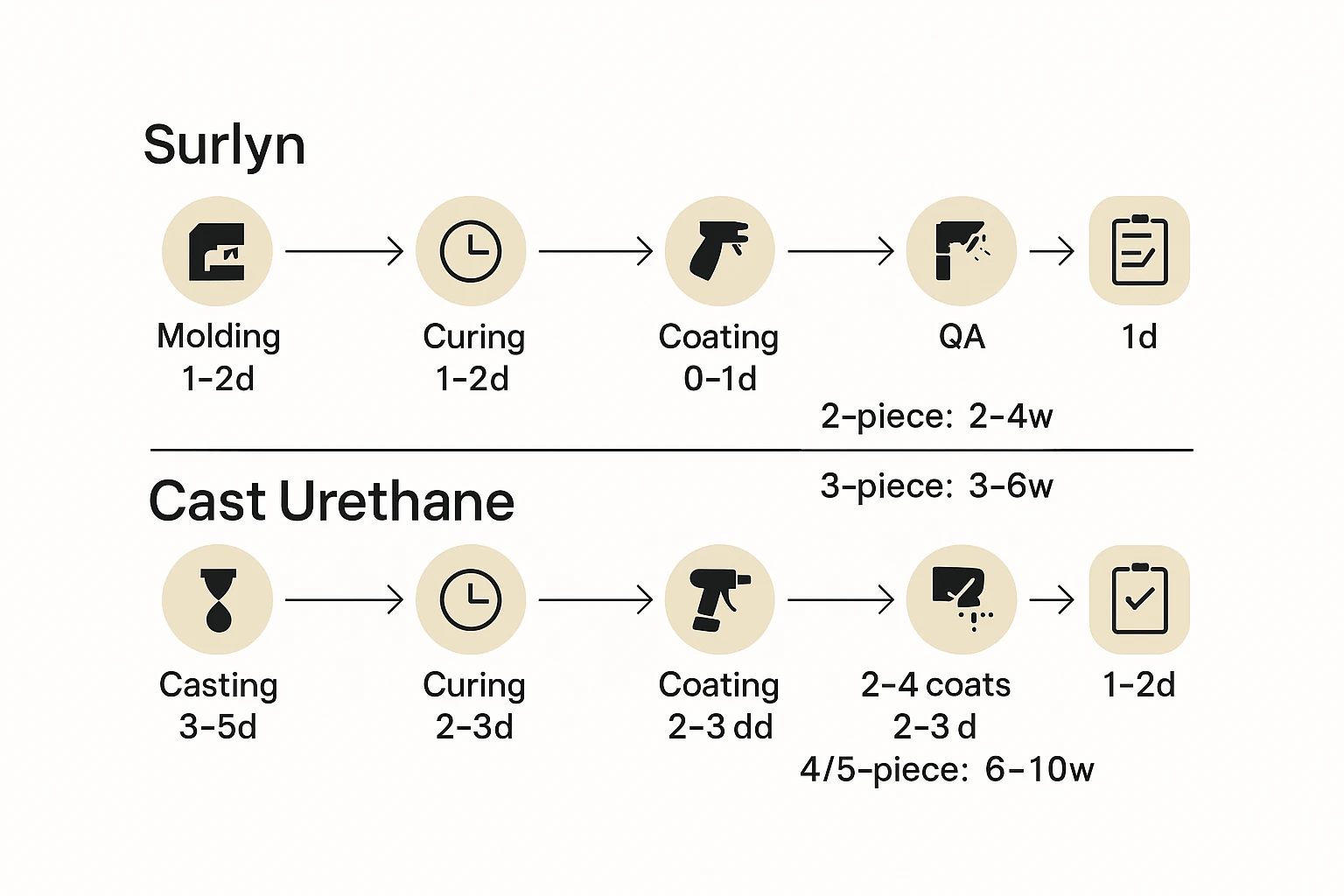

Cast urethane is not a slower version of Surlyn; it runs on a different chemistry clock. Your premium order needs curing, post-cure, coating stabilization, and QC release time because rushing the cover can risk feel, durability, wedge spin, and batch consistency.
Seconds vs Hours in Cover Chemistry
Surlyn and cast urethane do not share the same production rhythm. One behaves like a fast thermoplastic route; the other depends on a controlled reaction and release window.
Surlyn and ionomer covers follow a thermoplastic route: melt, inject, cool, eject. Under tuned conditions, thermoplastic injection can be measured in seconds. That is why simple 2-piece and 3-piece Surlyn orders can compress faster when materials, tooling, artwork, and line slots are ready.
Cast thermoset urethane is different. It uses a reactive cover route: mix, cast, gel, demold, post-cure, stabilize, coat, and release. The exact timing depends on the formula, equipment, cover thickness, coating stack, and factory release test. Post-cure time is not idle time; it helps the cover reach the properties needed for feel, durability, and short-game control.
| Pain / decision | Surlyn / ionomer route | Cast urethane route | Buyer action |
|---|---|---|---|
| Process clock | thermoplastic injection | reactive casting and curing | Request cover route. |
| Cycle logic | mold, cool, eject | gel, demold, post-cure, stabilize | Request curing buffer. |
| Rush potential | easier to compress if line is open | limited by chemistry and QC | Do not force unsafe rush. |
| Quality risk | surface/cosmetic and compression gates | cover hardness, bubbles, spin, coating, durability | Require no-pack release gate. |
A failure signal appears when a supplier promises cast urethane rush without any curing buffer. That may mean the factory is not actually quoting cast thermoset urethane, or it may be hiding quality risk behind a heroic delivery promise. A beautiful promise is still a risky promise if the cover has not stabilized. Chemistry does not speed up because a launch calendar is sweating.
Request a written curing buffer covering gel, demold, post-cure, coating stabilization, no-pack release, and final QC. Verify whether the supplier is quoting injection-molded TPU urethane, ionomer / Surlyn, or cast thermoset urethane. Do not accept rush delivery for cast urethane unless the factory states which curing and QC gates remain unchanged.
For cast urethane balls, supplier shall include curing, post-cure, coating stabilization, no-pack release, final QC, and retained-sample review in the production schedule. Buyer shall not require shipment before the agreed curing and QC windows are completed.
Where Do Factory-Floor Delays Happen?
A perfect pilot sample can arrive quickly, then bulk production slows when the factory has to repeat the same ball thousands of times.
Mass production lead time often disappears inside QA and rework loops. Your pilot sample proves the factory can make the ball once; bulk production proves whether it can repeat shell thickness, concentricity, compression, coating, print quality, and cosmetics across thousands of balls.
QA and Rework Loops
Bulk production is not a bigger sample run. It is a repeatability test under heat, pressure, curing variation, coating queues, print setup, and inspection limits.
The factory floor has more gates than most RFQ spreadsheets admit. Material readiness must be confirmed. Core and mantle forming must match the approved construction. Cover forming or casting must stay inside thickness and cosmetic limits. Coating ovens need dwell time and queue space. Printing must match approved artwork. Final QC must release the batch, not just admire a good dozen.
Premium urethane increases the risk. Thin cover profiles, tight compression windows, bubbles, coating defects, weight drift, diameter variation, and eccentric layers can trigger hold, sort, scrap, or rework. For higher-end programs, acceptance rules should be tied to the agreed product, test method, sample ID, batch ID, and raw QC data—not a generic promise.
| Factory-floor gate | What can delay it | Buyer risk | Evidence to request |
|---|---|---|---|
| Material readiness | resin, rubber, color, tooling not ready | schedule starts late | Request material-ready date. |
| Cover forming / casting | gel, cure, thickness drift | urethane calendar expands | Request cure and cover-thickness plan. |
| Coating / ovens | dwell time, queue, defects | finished balls wait before print | Request coating slot and no-pack release. |
| Final QC | compression spread, eccentricity, bubbles | hold / sort / scrap / rework | Request FPY, scrap log, retained samples. |
| Release | sample mismatch or packaging mismatch | EXW date slips | Request approval checklist. |
A failure signal appears when a bulk schedule lacks FPY, scrap, and rework rules. If the quote assumes perfect first-pass yield, your delivery date may be more optimistic than operational.
Request a batch-control schedule showing FPY target, scrap threshold, rework rule, compression distribution, cover-thickness distribution, retained sample policy, and final release owner. Verify whether the supplier’s lead time assumes first-pass yield or includes realistic rework buffer. Your PO should permit hold, sort, scrap, or rework when agreed gates fail, while requiring immediate buyer notification and a revised EXW date.
For a deeper QC workflow, review Golf Ball QC in China: The 4 Must-Have Testing Processes before approving premium urethane production.
✔ True — Rework delay can protect your brand.
A factory that scraps or reworks out-of-window balls may be protecting your launch from bad reviews, returns, and inconsistent playability.
✘ False — “A perfect pilot sample guarantees bulk production speed.”
A pilot sample proves possibility. Mass production proves repeatability under heat, pressure, curing, coating, printing, and inspection variation.
How Can Packaging Delay Finished Balls?
Packaging looks harmless until a late barcode, Pantone change, sleeve dieline, or premium insert becomes the new critical path.
Use Day 3–5 after PO as a practical packaging freeze target when the order uses custom sleeves, boxes, barcodes, inserts, or carton marks. Run packaging in parallel with ball production instead of waiting until the balls are finished.
Run packaging in parallel
Packaging is not decoration after production. For OEM golf balls, the box, sleeve, barcode, carton marks, and inserts are their own production line.
The ball factory may be on schedule, but a late artwork revision can still make finished balls sit in cartons while printed sleeves, dozen boxes, or premium gift boxes catch up. That is the kind of delay that feels silly until it costs a launch window.
The rule is simple: lock dieline, Pantone, barcode, warning text, recycling marks, carton marks, and insert structure as early as possible after PO. For custom retail packaging, Day 3–5 is a useful freeze target, not a universal guarantee. While Surlyn balls are molding or urethane balls are curing and coating, the packaging supplier should already be proofing, printing, laminating, UV finishing, and preparing inserts.
| Packaging decision | If delayed | Schedule effect | Buyer action |
|---|---|---|---|
| Dieline | box cannot enter proofing | packaging start slips | Freeze early; Day 3–5 is a useful target for custom packaging. |
| Pantone / artwork | repeated color proofing | print date moves | Approve digital proof fast. |
| Barcode / warning text | reprint risk | finished goods wait | Approve compliance text early. |
| Premium insert / EVA / blister | extra material lead time | packaging becomes critical path | Quote and schedule separately. |
| Carton marks | warehouse readiness delay | EXW release confusion | Lock before mass print. |
Request a parallel packaging schedule that locks dieline, Pantone, barcode, carton marks, warning text, recycling marks, insert structure, proof owner, approval deadline, and packaging production start date before packaging becomes the critical path.
A failure signal appears when packaging files are still changing after Day 5. Verify whether packaging lead time starts after artwork approval or after PO deposit. Do not release mass production until packaging freeze date and approval owner are written into the production plan.
DTC launches fail when packaging and QA are scheduled after ball production. Your launch can miss its date even when the balls are finished if your team changes the box too late.
When Do China Holiday Buffers Matter?
A buyer who treats Chinese New Year as a one-week closure can unknowingly place an urgent PO into a multi-week capacity squeeze.
China holiday buffers should be treated as production seasons, not short office closures. Your launch can fail if specifications, packaging, pilot samples, mass-production release, or PSI are still open when factory capacity tightens.
Chinese New Year affects more than the official holiday week. Factories often reduce output before the break, workers return in waves, packaging suppliers rebuild queues, and QC or pack-out teams may not return to full rhythm immediately. National Day can create a smaller but still painful October squeeze.
For spring launches, planning backwards is safer than asking for a miracle forward. The more complex the SKU is, the earlier your team should freeze construction, artwork, packaging, sample approval, mass-production release, and QC gates.
| Holiday risk window | What usually tightens | Buyer risk | What to request |
|---|---|---|---|
| 8–10 weeks before CNY | materials, packaging, tooling, production slots | complex orders may miss safe production windows | Written cut-off and slot confirmation. |
| 4–6 weeks before CNY | labor planning, pack-out, QC, rework capacity | rush orders become harder to recover | PSI date and rework rule. |
| Official CNY closure | factory, packaging, trucking, documentation | production and release pause | Closure dates and restart plan. |
| 2–4 weeks after CNY | staffing return, supplier queues, QC rhythm | restart is slower than expected | Revised EXW plan. |
| National Day window | short production break and shipment congestion | final QC or release slips | Cut-off date and backup plan. |
Request a holiday buffer plan covering production cut-off, packaging cut-off, PSI date, cargo-ready date, and revised EXW date if rework occurs. Verify whether the supplier’s quoted lead time crosses Chinese New Year, National Day, peak export season, or local shutdown.

Your team cannot buy a rush miracle after the buffer zone starts. The safest rush order is one that was planned before the calendar tightened.
✔ True — CNY is a production-window problem.
The holiday affects material readiness, line access, packaging, staffing, QC, and pack-out. Treat it as a planning season, not a short office closure.
✘ False — “If the official holiday is one week, your order only needs one extra week.”
Late orders can hit reduced output before the holiday and uneven restart after it, especially when packaging or rework is still open.
Where Does EXW Stop in the Timeline?
Many schedule arguments happen because one team counts factory release while another counts warehouse arrival. Those are not the same timeline.
Stop counting this production timeline when the balls are EXW or cargo-ready. Your factory schedule covers sample approval, tooling, production, packaging, QC, and release. Freight, customs, DDP, warehouse arrival, and final delivery should be modeled in the dedicated logistics guide.
Use the EXW Timeline Boundary
This production timeline is a factory-floor document. It should end when the packed, inspected goods are ready under the agreed EXW or cargo-ready condition.
This production timeline covers quote confirmation, sample approval, tooling, material readiness, ball production, curing, packaging readiness, final QC or PSI, carton marking, palletization if required, and EXW release. It should not carry the burden of ocean transit, air transit, duty, customs, port congestion, DDP, last-mile delivery, or warehouse arrival.
That boundary protects planning clarity. Your production team should own EXW readiness. Your logistics team should own delivery timing. Mixing both creates bad KPIs, confused launch meetings, and at least one spreadsheet that nobody wants to open.
| Timeline item | In this article? | Owner | Buyer action |
|---|---|---|---|
| Sample approval | yes | buyer + factory | Lock golden sample. |
| Production and curing | yes | factory | Approve process schedule. |
| Packaging production | yes | buyer + packaging supplier | Freeze early; Day 3–5 is a useful custom-packaging target. |
| Final QC / PSI | yes | factory / inspector | Require release report. |
| Ocean / air transit | no | logistics provider | Use logistics guide. |
| Customs / duty / warehouse | no | broker / importer | Use landed-cost model. |
Request an EXW release definition showing what document, inspection, packing status, and cargo-ready condition triggers completion. Verify whether the factory timeline includes packaging, PSI, carton marking, palletization, and export-ready documentation. Do not merge production timeline and delivered-cost timeline in the same KPI unless the quote explicitly uses DDP.
For delivery timing after EXW, use the China golf ball landed-cost guide to model freight, customs, DDP assumptions, and warehouse arrival separately.
FAQ
Can you rush order custom golf balls?
Yes, custom golf balls can sometimes be rushed, but only when construction, approved samples, existing tooling, artwork, packaging, line availability, and QC gates allow it. Cast urethane cannot safely skip curing or final release checks.
Simple 2-piece or 3-piece Surlyn orders using existing molds and basic pad printing are easier to expedite when the line has an open slot. Cast urethane should not skip curing, coating stabilization, or final QC because paying more cannot safely compress chemistry. To protect your date, freeze construction, logo, packaging, and acceptance criteria before asking the factory for a rush slot.
Why do custom golf balls take so long to make?
Custom golf balls take time because an OEM project includes sample approval, material readiness, tooling, molding or casting, curing, coating, printing, packaging, QC, retained-sample release, and EXW handoff—not only ball forming.
Most delays come from hidden coordination gaps: artwork changes, late packaging files, missing barcode approvals, tooling not ready, unclear sample status, or QC rework after bulk production starts. A strong OEM golf ball lead time is a managed workflow, not a single machine cycle. Keep shipping questions in a separate logistics plan.
How long does cast urethane need to cure?
Cast urethane cure timing varies by formula and process, but premium urethane production usually needs gel, demold, post-cure, coating stabilization, no-pack release, and QC buffers before the balls are packed.
Initial gel may be shorter than the full production window, but the ball still needs enough process time to protect cover durability, feel, wedge spin, coating performance, and batch consistency. Ask the supplier for the curing buffer in writing. Do not accept a fixed universal cure claim unless it is tied to the factory’s actual formula, equipment, and release test.
Does tooling for new dimple patterns increase lead time?
Yes. Existing public tooling usually moves faster, while private dimple or aerodynamic tooling can add CAD, CNC, polishing, trial molding, pilot validation, mold correction, and QC review before mass production.
Private tooling may be worth it for a mature brand with a validated demand plan, but it is rarely the fastest route for a first pilot. Ask for a tooling Gantt, ownership terms, approval gates, trial-shot timeline, and mold-revision rules before PO. Public tooling can be a safer low-risk route when speed and validation matter more than proprietary aerodynamics.
Why does packaging delay finished golf balls?
Packaging delays finished golf balls when dielines, Pantone, barcode, warning text, carton marks, inserts, or premium box structures are still changing after ball production has already started.
Treat packaging as a parallel production line. Freeze files early, use Day 3–5 as a practical custom-packaging target when possible, assign one buyer-side approval owner, and require digital proofs before packaging becomes the critical path. Premium boxes, EVA inserts, blister packs, foil, and UV finishing should be quoted and scheduled separately from basic sleeves. Your balls can be perfect and still miss EXW if the box is late.
Why did the bulk order take longer than samples?
A sample proves the factory can make the ball once; bulk production proves repeatability across thousands of balls, including compression, cover thickness, concentricity, coating, print, cosmetics, and retained-sample checks.
Bulk production adds real variation: machine temperature, material lots, coating dwell, print setup, and operator shifts. If yield drops, the factory may hold, sort, scrap, or rework affected units to protect your brand. Ask for FPY, scrap log, retained samples, and the rework rule before mass production begins.
How should I plan around Chinese New Year?
Plan backwards if your OEM golf ball order crosses Chinese New Year. Lock specs, packaging, samples, mass-production release, and PSI before capacity tightens around the holiday window.
Treat CNY as a multi-week production disruption, not a one-week office closure. Confirm factory cut-off, packaging cut-off, restart date, rework rule, and revised EXW plan in writing. Delivery timing after EXW belongs in your logistics plan, not your factory production promise.
Conclusion
The fastest OEM golf ball order is not the one with the shortest promise; it is the one with the clearest production gates. Your team should lock construction, tooling, artwork, packaging, curing buffer, QC rules, and EXW release before the schedule becomes a problem.
Request a production timeline pack with construction lane, sample approval date, tooling status, curing buffer, packaging freeze date, QC gate, rework rule, holiday buffer, and EXW release definition. Compare suppliers only after each timeline starts from the same trigger and ends at the same release condition.
