China golf ball OEM lead time can be as short as 12–18 days only under fast-lane conditions: an existing 2-piece Surlyn spec, white balls, simple pad printing, blank or standard packaging, deposit received, artwork approved on Day 0, available line capacity, and a signed latest ship date. Full-custom balls, UV artwork, retail boxes, peak season, or CNY timing need a longer schedule.
A supplier’s “20 days” can become 50 days when nobody defines when the clock starts. Artwork revisions, UV printing queues, custom color boxes, PSI booking, and CNY capacity can all delay shipment after the balls are physically ready.
Use this guide to separate factory lead time from delivery date, identify the real bottleneck, and write the PO clauses that protect your launch window before a verbal promise turns into a missed season.
What does lead time really mean?
You do not lose spring season because a supplier says “30 days.” You lose it because nobody wrote when those 30 days start, what they include, and what happens when they slip.
Lead time is not the same as delivery date. For China golf ball OEM orders, lead time should mean the factory clock from deposit and artwork approval to goods ready for shipment; your delivery date depends on handover, transport, and your Incoterm.
Many sourcing disputes begin with one lazy phrase: “Production takes 30 days.” Your team may hear “30 days from today.” The factory may mean “30 days after deposit, final artwork, packaging decision, and signed production specification.” That difference can quietly eat two weeks before the real countdown even begins.
Keep the logistics explanation short, but keep the responsibility line sharp. Factory lead time controls the production-ready date. Delivery date depends on handover, transport route, and your buyer-side receiving plan. This article focuses on the factory side because that is where the PO can remove bottlenecks.
Supplier promises “20 days” but refuses a start trigger is a failure signal. Your launch calendar needs written triggers, not friendly estimates.
| Pain/decision | Define this | Buyer risk | Action/evidence |
|---|---|---|---|
| Supplier says 20 days | Start trigger | Clock starts later than expected | Write deposit + artwork approval |
| Goods miss launch | Latest ship date | No hard backstop | Set date in PO/PI |
| Ball ready but not shipped | PSI window | Inspection delay | Pre-book PSI date |
| Arrival date unclear | Delivery date owner | Factory vs logistics confusion | Separate production from delivery |
| Rush plan changes | Packaging decision date | White box option missed | Lock first-drop pack choice |
✔ True — Lead time starts from a written trigger
For OEM golf balls, the clean trigger is usually deposit received, final artwork approved, packaging decision confirmed, and production specification signed. Without that trigger, the factory clock can slide.
✘ False — “Saying 30 days is enough to protect your launch”
A number without start date, PSI window, packaging status, and latest ship date will not protect your event, spring season, or customer commitment.
When does the clock actually start?
The clock should start only when deposit receipt, final artwork approval, packaging decision, and signed production specification are all confirmed.

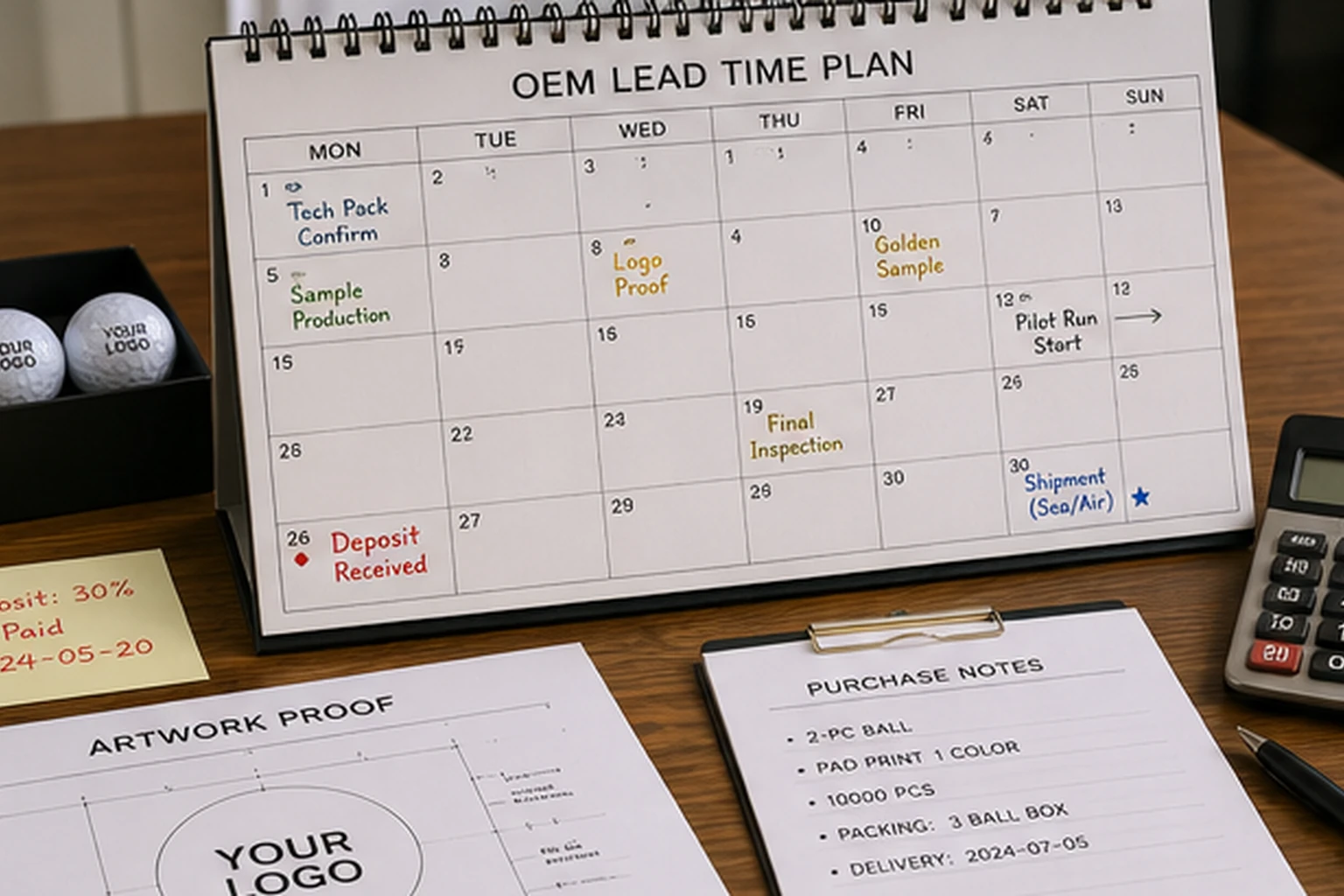

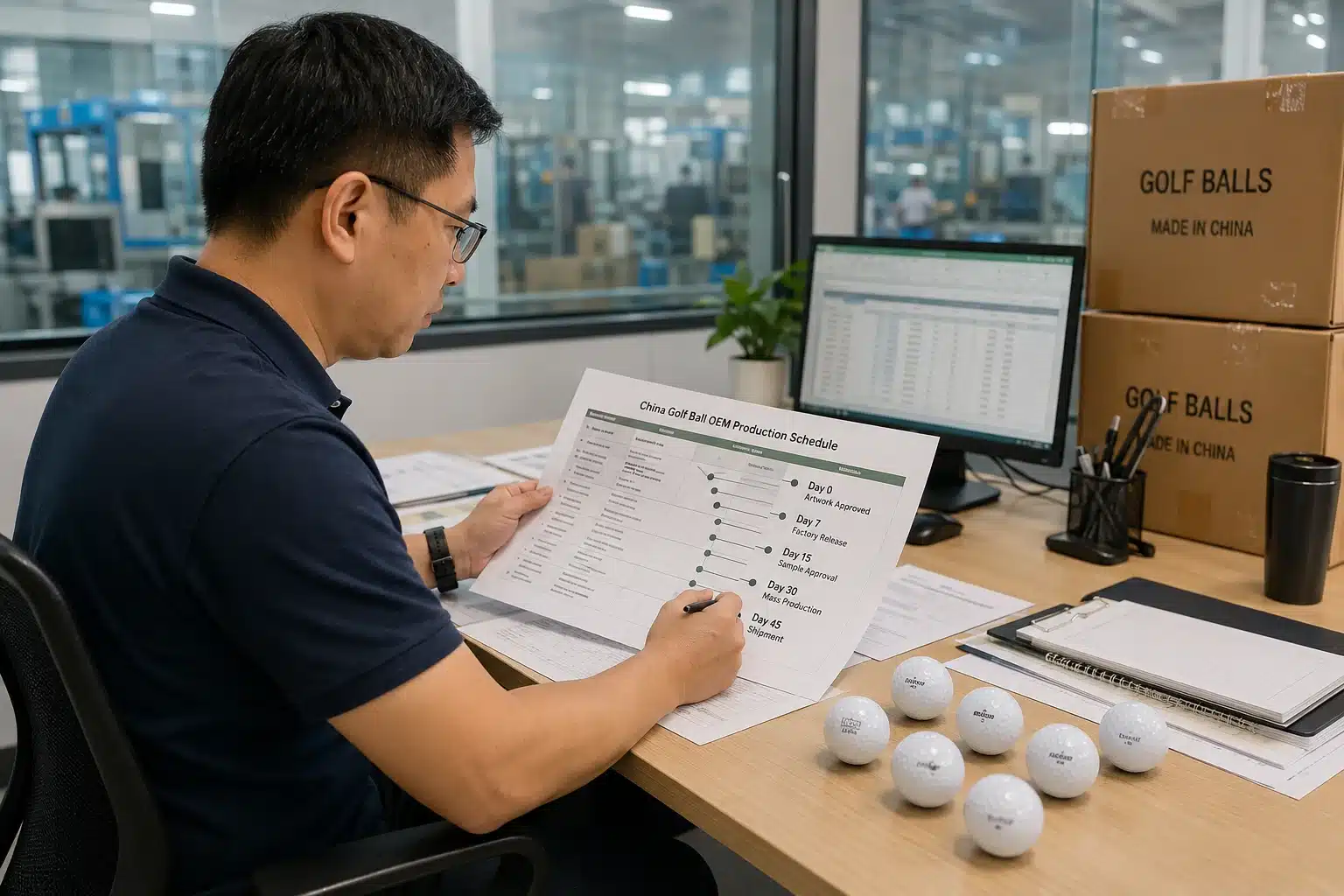

Request a production calendar showing start trigger, ball-ready date, print-ready date, packaging-ready date, PSI date, and latest ship date. Then check whether the supplier’s quoted lead time starts after deposit, artwork approval, packaging approval, or another condition. A serious China golf ball supplier can separate those steps before you release the PO.
Lead time starts only after deposit receipt, final artwork approval, packaging decision, and signed production specification are all confirmed. Supplier shall provide ball-ready date, print-ready date, packaging-ready date, PSI window, and latest ship date before production release.
Can China OEM production really hit 12 days?
A 12-day headline sounds attractive when your event date is close. It becomes dangerous when your order includes a new structure, complex UV artwork, retail color boxes, and peak-season timing.
A 12-day China OEM timeline is a fast-track condition, not a universal promise. It usually requires an existing 2-piece Surlyn structure, white balls, approved artwork, simple pad printing, blank or standard packaging, available line capacity, and no late design changes.
The 12–18 day fast lane is real only when the order removes slow choices before the PO is released. Existing mold, standard 2-piece Surlyn structure, white ball, fixed logo position, 1–4 color pad printing, blank box, and clean Day 0 approval can move much faster than a custom structure with UV artwork and retail packaging.
Think of this as a production-speed equation. Every custom choice adds time: new tooling, special cover, special color, new logo position, UV gradient, retail sleeve, premium carton, late Pantone changes, or unbooked inspection. Your timeline is only as fast as your slowest custom choice.
Rush windows below the normal fast lane may exist, but they are exceptional. They need a locked line slot, simplified specs, surcharge or priority agreement, and a QC gate that does not disappear under pressure. Speed without inspection is not speed; it is risk arriving early.
For buyers testing a small launch, speed and MOQ usually need to be planned together. Use this golf ball OEM MOQ and trial order guide when pilot quantity, cash exposure, and lead time must be aligned.
| Order path | Fastest fit | Risk | Action/evidence |
|---|---|---|---|
| 2-piece Surlyn, existing spec | 12–18 days possible | Line slot still required | Ask for rush-readiness checklist |
| 3-piece / PU custom | Longer window | Cover/coating/QC complexity | Confirm structure-specific lead time |
| Complex UV + color box | Not fast-lane | Print/packaging queue | Move complex items to wave two |
| US full-OEM route | Often not small-rush fit | Longer schedule / higher threshold | Verify before design work |
| Rush below 12 days | Exceptional only | Surcharge and quality risk | Require latest ship + QC gate |
What qualifies for the 12–18 day fast lane?
A fast-lane order qualifies only when your slowest custom choice has already been removed.
Ask for a feasibility reply before PO release. The reply should confirm structure, mold, ball color, logo method, packaging, line slot, Day 0 trigger, PSI window, and latest ship date. If the supplier cannot separate 2-piece, 3-piece, UV, packaging, and PSI timelines, the “12 days” promise is not controlled.
Use 12–18 days only if all fast-lane conditions are met. For custom structures, premium covers, complex decoration, or peak-season production, require a longer written schedule. The honest answer may hurt for five minutes, but it saves your launch.
Why are finished balls still delayed?
Your balls can be molded and coated, yet the shipment still waits because printing, color changes, custom boxes, PSI, or CNY recovery becomes the longest bar in the schedule.

In golf ball OEM production, the molding line is rarely the only clock. A shipment can sit after the balls are ready because custom boxes, multi-color logo approval, UV print queues, PSI booking, or CNY workforce recovery controls the real ship date.
This is the pain behind many China golf ball supplier delivery delay complaints: the ball is physically done, but the order is not shipment-ready. The delay is hiding in the critical path. It may be UV print queue, Pantone approval, logo registration, packaging proof, barcode label, master carton, PSI booking, or a subcontracted color box vendor.
Packaging is often the hidden critical path because custom boxes have their own proofing, printing, cutting, folding, and production timeline. Packaging lead-time references show how custom packaging timelines can vary by format, with corrugated, folding carton, and rigid-box projects each carrying different production windows after artwork approval. That is why “ball-ready date” and “packaging-ready date” must be separate lines in the PO calendar. For urgent first-wave supply, blank box golf ball packaging with a barcode label can protect the launch while printed retail boxes move to wave two.
Ball is finished but packaging or UV queue has no date is a failure signal. The buyer’s better question is not “Are the balls done?” It is “Which step controls the ship date, and what can we simplify for wave one?”
| Bottleneck | Typical delay risk | Why it happens | Action/evidence |
|---|---|---|---|
| Custom color box | Days to weeks | External printer queue | Use blank box for first drop |
| Complex UV logo | Print queue / curing | Machine setup and approval | Shift wave one to pad print |
| Artwork revisions | Lost start date | Pantone/file changes | Freeze vector file early |

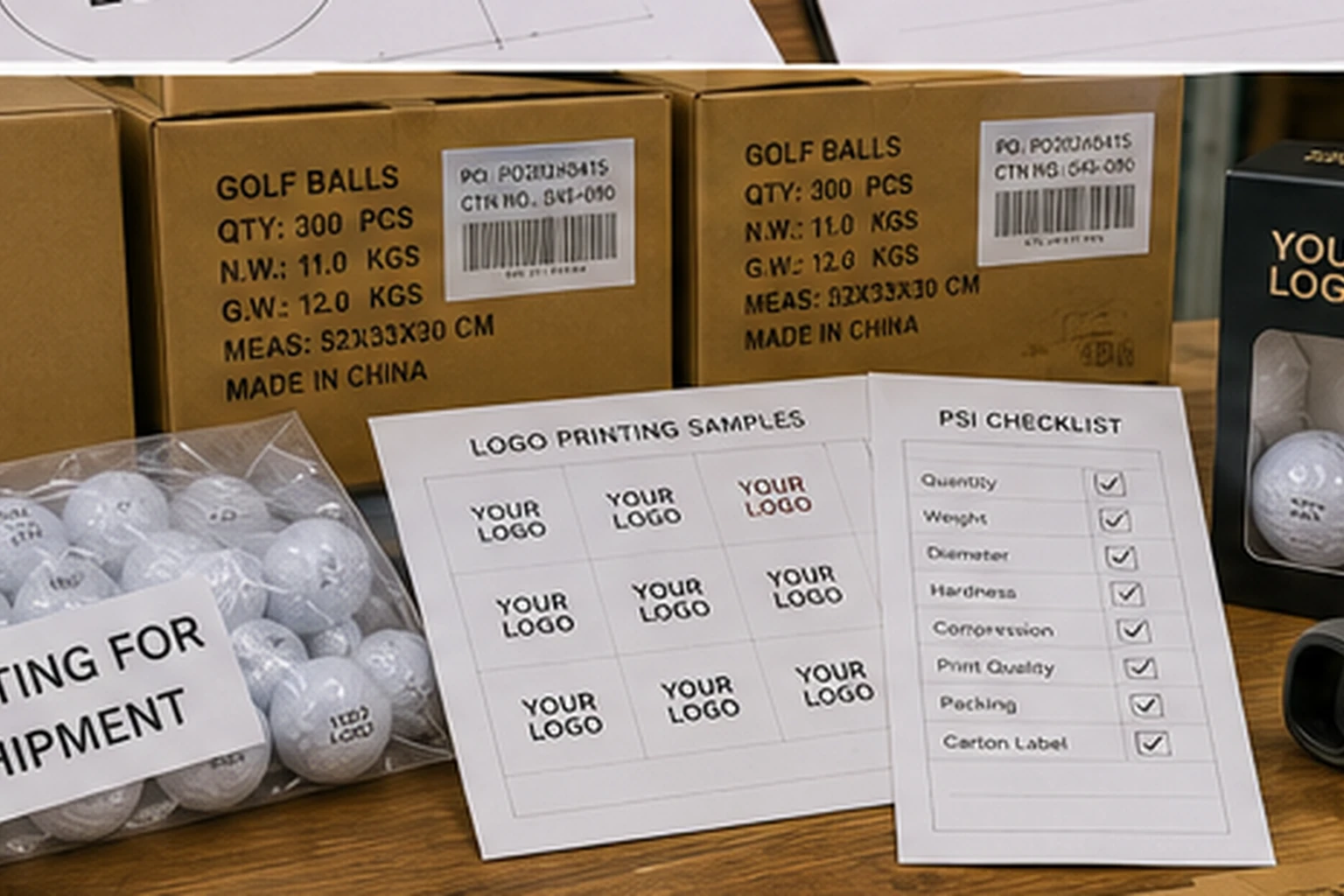

| PSI booking | Release delay | Inspector shortage | Pre-book PSI window |
| CNY / peak season | Capacity gap | Labor and vendor disruption | Lock Oct–Dec or post-CNY |
✔ True — Ball-ready does not always mean shipment-ready
A golf ball order can be physically produced but still blocked by logo printing, packaging, PSI booking, labels, carton proofing, or vendor recovery after peak disruption.
✘ False — “Only the molding line defines lead time”
Molding is only one bar in the schedule. The longest bar controls the ship date, and it is often decoration, packaging, or inspection.
What is the hidden critical path?
The hidden critical path is the step that controls shipment even after the balls are physically ready.
Request separate dates for ball-ready, print-ready, packaging-ready, PSI, and latest ship. Then ask which step can be downgraded for wave one. If launch timing is urgent, the PO should allow blank box, barcode label, simplified logo, or first-drop release before final retail packaging.
In golf-ball OEM production, the rush plan should look like this: in-house ball spec, white balls, 1–4 color pad print, blank boxes, barcode labels, pre-booked PSI, and a latest ship date. Complex UV artwork and retail color boxes can move to wave two. That is not a downgrade; it is launch protection.
Which specs should you simplify first?
If your launch date matters more than perfect first-wave artwork, complex UV gradients, repeated color changes, and custom packaging can buy delay instead of value.
The fastest lead-time cut often comes from simplifying decoration, not rushing the core ball process. For wave one, a fixed-position 1–4 color pad print and blank box can protect your launch while complex UV artwork and retail packaging move to the second wave.
Pad printing fits simple 1–4 color logos, repeated marks, range ball numbers, event logos, and cost-sensitive or time-sensitive orders. UV printing fits gradients, photo-style designs, personalization, and complex multi-color artwork. UV is powerful, but it can add approval loops, machine queue risk, curing control, and extra inspection steps.
Every logo change is a production changeover. Pantone changes, new plates, ink viscosity adjustment, position changes, adhesion checks, and repeated proofing can consume the schedule. When people say “just change the logo color,” factory planners hear setup, registration, line clearance, and approval risk. A rushed buyer sees design. A production planner sees time tax.
For urgent orders, simplify the first wave. Use 1–4 color pad printing in a fixed position, approve a physical print sample, and ship first drop in blank box or generic packaging with barcode label. Then upgrade UV gradients, retail packaging, foil stamping, or premium display packs on the second wave. For more print-method detail, see golf ball logo printing methods.
| Spec choice | Speed effect | Trade-off | Action/evidence |
|---|---|---|---|
| 1–4 color pad print | Shorter print path | Less digital color freedom | Approve physical print sample |
| Complex UV gradient | Longer queue risk | Better visuals | Move to second wave if urgent |
| Blank white box | Bypasses box printer | Less shelf impact | Use barcode label first |
| Retail color box | Packaging critical path | Better branding | Approve for wave two |
| Fixed logo position | Less setup risk | Less layout freedom | Lock vector + Pantone |
When should pad printing replace UV?
Pad printing should replace UV when speed matters more than complex first-wave artwork.
Request two schedules: full-custom UV/packaging and speed-first pad-print/blank-box first drop. Compare print approval, packaging approval, PSI timing, and ship date across both schedules. Use simplified wave one only if logo legibility, approved artwork, barcode label, and market requirements are still acceptable.
The first wave does not need to win a packaging award. It needs to arrive before your launch window closes.
How do you avoid the CNY delay trap?
A January urgent order can become a March headache because factory labor, packaging vendors, inspectors, and suppliers do not return to normal capacity immediately after CNY.

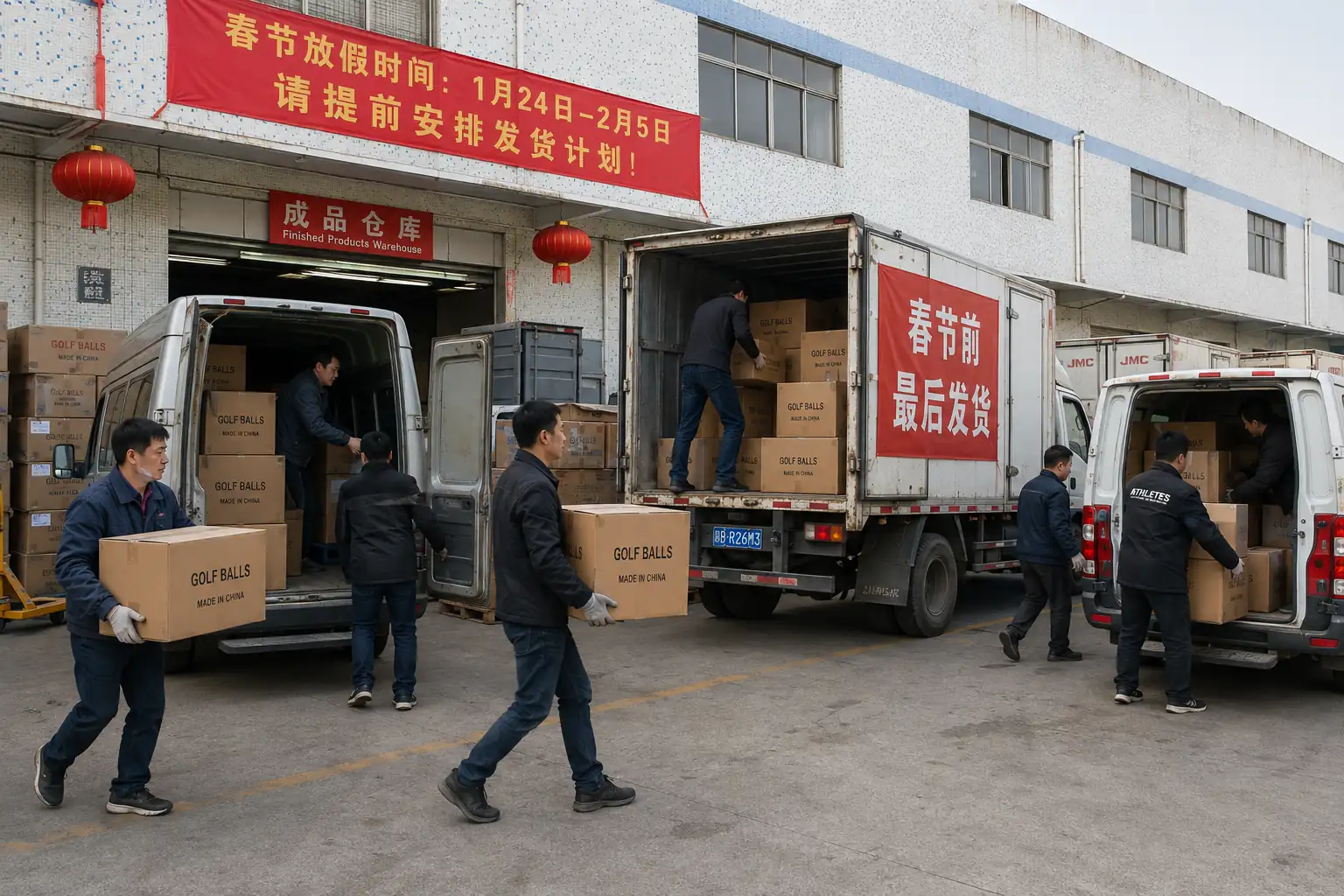

Chinese New Year is not a one-week production pause; it is a capacity event. For the 2026 CNY planning window, spring orders are safer when deposit, artwork, packaging decision, and PSI window are locked in October–December, not mid-January.
Chinese New Year is not a one-week production pause. Flexport notes that factories are closed or operating at diminished capacity for at least four weeks around CNY. For golf ball OEM orders, that means every supporting step can wobble: compounding, coating, printing, packaging, carton labels, PSI, and production scheduling. Flexport CNY guide
For the 2026 CNY planning window, SEKO notes that the first 2–3 weeks of March may still be a gradual resumption period, with factories reopening below full workforce capacity. The brutal lesson is useful: your spring season is decided before CNY begins. A mid-January urgent order may be accepted by sales, but trapped by operations. SEKO 2026 Lunar New Year guide
Use October–December to lock deposit, artwork, line slot, simplified packaging, and inspection window. Use post-CNY only with a written recovery plan, vendor confirmation, and first-drop option. Do not plan final QC in the middle of the CNY risk zone and then act surprised when the calendar fights back.
| Timing decision | Factory reality | Buyer risk | Action/evidence |
|---|---|---|---|
| Oct–Dec PO | Lower queue pressure | Best chance to pull dates forward | Lock deposit + artwork |
| Mid-Jan urgent order | CNY wind-down | Spring launch miss | Avoid if possible |
| CNY week | Shutdown / low capacity | No normal production rhythm | Do not plan final QC |
| Early March | Recovery not full capacity | False restart assumption | Confirm workforce and vendors |
| Apr–Aug peak | Export queue high | Fewer rush options | Use first drop + clauses |
✔ True — CNY planning starts months before the holiday
The safest spring-season plan locks specs, deposit, packaging, line slot, and PSI window before factories and vendors begin slowing down.
✘ False — “A factory reopening date means full production capacity is back”
Reopening is not full recovery. Labor, vendors, inspections, and backlogged orders can keep the schedule tight well into the restart period.
When should spring orders be locked?
Spring orders should be locked before the factory calendar starts to bend. For practical China golf ball OEM planning, October–December is the safer window for deposit, artwork, packaging decision, and line-slot confirmation.
Request a CNY or peak-season production plan with deposit deadline, artwork deadline, packaging deadline, PSI date, and latest ship date. Ask whether external packaging, print, and PSI partners will operate normally during the planned window.
Do not approve a January or February urgent order unless the supplier confirms vendor capacity, first-drop option, simplified packaging path, and latest ship remedy. Your spring season needs a sourcing calendar, not a panic email.
What PO clauses protect your launch date?
Verbal urgency does not allocate risk. If the supplier misses the production date, your team needs a written remedy that protects the launch without destroying the relationship.
The strongest lead-time negotiation is a written PO clause, not an urgent email. Define the start trigger, latest ship date, first drop percentage, PSI window, cure period, packaging downgrade option, and sea-to-air freight remedy before production starts.
The most useful lead-time clause is not hostile. It is clear. It tells both sides what date matters, what quantity must move first, what packaging can be simplified, and what remedy applies if the delay is supplier-controlled. “We will try our best” may be polite, but it does not allocate risk when a spring launch is slipping.
First drop shall ship no less than 25% of the PO quantity by the agreed latest ship date using approved simplified packaging if retail packaging is not ready. If shipment misses the latest ship date after a five-day cure period for supplier-controlled causes, supplier shall bear the agreed sea-to-air freight difference for the delayed first-drop quantity.
That clause does three jobs. It protects first-wave supply, gives the factory a practical packaging downgrade option, and makes delay more expensive than planning properly. Supplier agrees urgency but avoids latest ship remedy is a failure signal.
| Clause | Purpose | Risk if missing | Acceptance / action |
|---|---|---|---|
| Start trigger | Fixes clock start | Supplier shifts timing | Deposit + artwork approved |
| Latest ship date | Creates hard backstop | Launch slips quietly | Write date in PO |
| First drop 25% | Protects launch supply | All goods wait for packaging | Release simplified wave one |
| PSI window | Avoids final release delay | Inspector unavailable | Book before latest ship |
| Air-freight remedy | Allocates late risk | Buyer pays delay cost | Define trigger and calculation |
| Cure period | Keeps clause practical | Unrealistic penalty dispute | Use clear days and exceptions |
How does an air-freight remedy work?
An air-freight remedy works when the PO defines the late trigger, delayed quantity, service level, calculation basis, and responsibility for supplier-controlled delay.
Do not rely on urgency. Add a PO clause bundle covering start trigger, latest ship date, first drop, PSI, cure period, packaging downgrade option, and air-freight remedy. Then check whether the supplier agrees to exact dates, quantities, trigger events, and remedy calculation.
Quote the fastest production plan using an existing 2-piece Surlyn spec, white balls, 1–4 color pad printing, standard logo position, blank box or generic packaging, and first drop 25%. Confirm start trigger, ball-ready date, packaging-ready date, PSI window, latest ship date, cure period, and air-freight remedy.
If you are still evaluating whether a supplier can honor rush dates, this China OEM supplier audit guide can help your team screen capacity, communication, and evidence habits before the PO is signed.
FAQ
How long does it take to manufacture custom golf balls in China?
A simplified China golf ball OEM order can move quickly, but the range depends on structure and customization. Existing 2-piece Surlyn specs with white balls, simple pad printing, and blank packaging may fit a 12–18 day production window; custom structures, UV artwork, retail boxes, peak season, or CNY can push timelines much longer.
Ask when the production clock starts, and separate ball-ready from shipment-ready. Confirm whether packaging and PSI are included in the timeline. A fast quote that ignores printing, packaging, and inspection is not a reliable launch schedule.
Can China golf ball production really be done in 12 days?
Sometimes, but only under fast-lane conditions. The order should use an existing spec, approved artwork, simple logo method, blank or standard packaging, available capacity, and no late changes. A full-custom order should not be judged by the same 12-day target.
Use existing molds/specs, choose simple pad printing, avoid custom boxes for wave one, and write a latest ship date. If the supplier cannot confirm line slot, print method, packaging plan, and PSI window, the 12-day claim is not controlled.
Why is my Chinese manufacturer delaying my order?
The delay may not be the molding line. Golf ball orders often slip because of custom packaging, UV printing queues, artwork revisions, PSI availability, CNY recovery, or missing payment and artwork approvals. The fastest fix is to identify the bottleneck, then simplify wave one.
Ask for the current bottleneck, not just a new promise. Request separate dates for ball-ready, print-ready, packaging-ready, PSI, and latest ship. Move noncritical custom work to wave two when the launch window is more important than perfect first-wave presentation.
How can I speed up production lead time with a supplier?
Do not only say the order is urgent. Offer a speed-ready plan: existing spec, approved files, pre-booked PSI, simple pad printing, blank boxes, first drop 25%, and a PO clause with a latest ship date. That gives the factory a real path to accelerate.
Simplify the first wave, lock payment and artwork early, and use first drop for launch supply. Put remedy terms in writing so the supplier has a clear operational target, not just pressure from your inbox.
Does paying more guarantee faster lead time?
No. In peak season, capacity can be more important than price. Payment can help secure a slot, but it cannot remove UV print queues, packaging delays, CNY recovery, missing approvals, or a supplier’s already-full production line.
Use payment as one lever only. Simplify specs first, then confirm line slot, packaging vendor capacity, PSI timing, and latest ship date. For deeper payment-term strategy, see this China golf ball OEM pricing negotiation guide.
Is an air-freight penalty clause practical?
Yes, if it is written clearly. The clause should define the latest ship date, cure period, delayed quantity, service level, and who pays the sea-to-air freight difference for supplier-controlled delay. It is most useful for protecting the first drop.
Use it mainly for the first drop. Define the calculation basis and keep force majeure narrow. Pair the clause with a PSI window and a packaging downgrade option so the supplier has a practical way to meet the date.
Conclusion
China golf ball OEM lead time is not shortened by pressure alone. It is shortened by removing bottlenecks, simplifying wave one, locking deposit and artwork early, avoiding CNY traps, using first drop 25%, and writing latest ship remedies into the PO.
If your launch window matters, do not ask only, “How fast can you make it?” Ask which spec, print method, packaging route, PSI window, and PO remedy make the date real.
You might also like — What Golf Balls Are Manufactured in China? The 2026 OEM Capability Report
